From the Maximo Support Desk - Functionality of PM Work Order Generation for PM Forecasts, Time-Based Frequencies, and Meter-Based Frequencies
Body
"What to expect when you're expecting a Work Order"
There are a few scenarios regarding PM Work Order Generation that are frequently misunderstood, or not precisely documented previously. In some cases, the results are unexpected by some
Maximo users...
- If there is a Forecast for a PM, which has populated a Forecast Date on the PM, then a Work Order will generate on that date. The Work Order will generate on this date regardless of
whether the PM is set up to only generate Work Orders when a meter frequency is reached. The summary is that the Forecast Date overrides any meter frequency that is currently applied to
the PM.

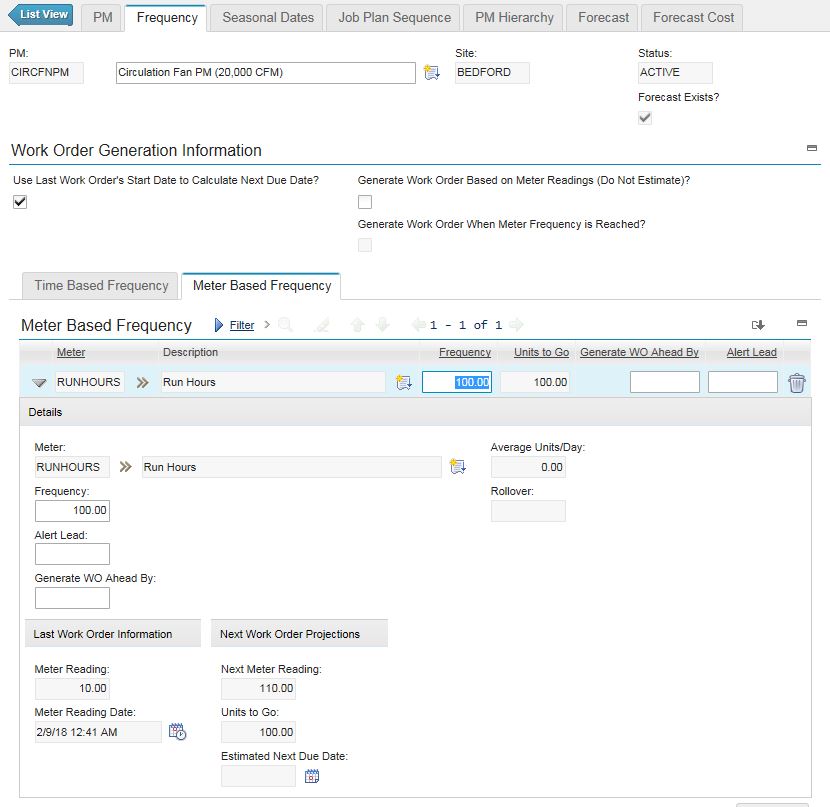

- If a PM has both a time-based frequency and a meter-based frequency associated to it, then the Work Orders will generate upon whichever of these frequency intervals is met first. In
other words, if a PM has a time-based frequency of 3O days as well as a meter based frequency of 100 hours, then a Work Order will get generated at either 30 days, or at 100 hours,
whichever happens first.

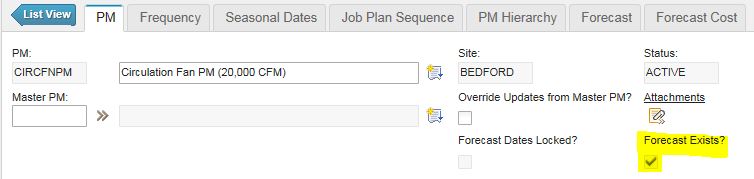

*In the above example, the Forecast Date will overrule either frequency, and the Work Order will generate upon the Forecast Date. (note that the Forecast Exists checkbox is selected):
If you need to forward this information to your Users or colleagues, I have also published this in an IBM knowledge-base type format:
http://www-01.ibm.com/support/docview.wss?uid=swg22013477
